Source: Barton Willmore for UKOG (GB) Ltd
The South Downs National Park has published plans by UK Oil & Gas Investments for 20 years of oil production at Markwells Wood in West Sussex.
A public consultation will last for five weeks until 28 October 2016 and the application will be discussed at a special meeting of Stoughton parish council on Monday (3 October 2016).
The application includes drilling a new horizontal well from the existing borehole at the site, as well as up to three additional production wells and a water disposal well.
Application details
DrillOrDrop has picked out key facts from the planning application. The full documents can be read here. In future posts, we’ll report on reaction to the application and its progress through the planning system.
Applicant
Site operator: UKOG (GB) Limited
Agent: Barton Willmore LLP, Cambridge
Application reference: SDNP/16/04679/CM and link
Proposed site
Address: South Holt Farm, Back Lane, Forestside, Stoughton, West Sussex
Size: 1.58ha
Location: 600m north of the village of Foreside and 1.3km east of West Marsden
Nearest homes: 565m away
Site access: Joins public highway east of Northwood Farm, on the north side of Forestside, 100m west of the junction with Stansted Park Road
Protected landscapes: In the South Downs National Park
Landscape Character Area: Stansted to West Dean Wood Estate Downland
Nearest designated wildlife site: Pads Wood Site of Special Scientific Interest, 4km to north east
Nearest heritage: Three Grade II listed buildings at Buckleys (0.6km), North Farm House and a barn. Stansted Park Grade II registered park and garden are 0.9km to the south.
Flooding: Flood Zone 1 – low risk of flooding
Site description: Hard standing of existing wellpad with a capped well, storage containers, bunded former storage tank and access road.
Petroleum Exploration and Development Licence area: PEDL126

Image: GoogleMaps
Planning history
January 2009: West Sussex County Council granted initial planning permission for site construction, drilling, testing for oil and restoration (SO/3152/07).
2010-2011: Well site constructed and drilled.
2011/2012: Testing confirmed presence of oil
January 2013: Extension of planning permission
November 2013: Extension of planning permission
October 2015: Extension of planning permission
Development proposals
The application is for 25 years, including 20 years for oil extraction
Site enabling works
- Create passing place on access road
- Construct compound
- Install welfare cabins
Total duration: 28 days

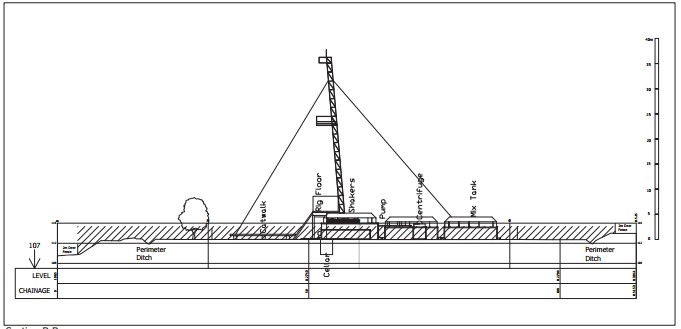

Drilling rig for side-track well. Source: Barton Willmore for UKOG (GB) Ltd
Phase 1 – appraisal and drilling
- Mobilisation of 37m workover rig – 2 days
- Permanently sealing and abandoning bottom of MW-1 well with cement plugs at 5,400ft-4,900ft and 4,300ft-3,800ft – 4-10 days
- Workover rig demobilisation – 2 days
- Mobilisation of 37m drilling rig – 4 days,
- Drilling 3,280ft (1,000m) horizontal side-track well – 36-40 days
- Acidisation – 4 days (including mobilisation, set-up, operation and demobilisation)
- Rig demobilisation – 4 days
- Construction of extended well test facilities – 120 days
- Extended well test of MW-1 – 6-12 months
Working hours: Deliveries 7am-7pm Monday-Friday, 7am-1pm Saturday. Operational hours 24 hours, seven days a week
Total staff on site: 23-33, including security
Waste: Any gas would be flared and produced water exported by road tanker
Fencing: 2m high wooden and wire mesh
Phase 2 – production
- Rig mobilisation – 4 days
- Drilling of water injection well – 30 days
- Drilling three additional wells (MW-2, MW-3, MW-4) – 132-140 days
- Rig demobilisation – 4 days
- Construction of production facilities – 180 days
- Production for up to 20 years
Working hours: Deliveries 7am-7pm Monday-Friday, 7am-1pm Saturday. Operational hours 24 hours, seven days a week
Total staff on site: 23-33, including security
Fencing: 2.4m high wire mesh security
Waste: Any excess gas would be used to generate heat and electrical power to be fed into the grid. Produced water and site rainwater reinjected via injection well.
Produced oil: Crude oil would be stored on site before being loaded for transport to the Holybourne rail terminal where it would be sent to the Fawley oil refinery.
Phase 3 – restoration
At the end of production, the wells would be plugged and abandoned and the site restored.
- Workover rig mobilisation – 2 days
- Plugging and abandoning of wells and restoration of site – 38 days
- Workover rig demobilisation – 2 days
Total staff on site: 10-14
Traffic
The application says the maximum number of two-way heavy goods vehicle (HGV) movements per day will be 20. This will be during mobilisation and demobilisation of the rigs.
During the 20-year production period, the application predicted “a minimal increase in traffic volumes” from the site.
According to the application, the construction phase “would lead to a temporary increase” in traffic on the proposed traffic route. On average, it suggested an increase in traffic movements of up to 16 two-way vehicle movements per day, or an extra 1.5%-2% on local roads.
The total number of lorry movements for each phase is very difficult to calculate from the application because movements are not listed for every phase of the operation. The estimated duration for each operation also varies between different documents in the application.
Based on information in the application, the following heavy goods vehicle (HGV) movements are estimated:
Site enabling works
10 two-way HGV movements
Phase 1: appraisal and drilling
- Drilling rig mobilisation: 20 two-way HGV movements
- Abandoning bottom section of well, drilling side-track and acidisation: 520 two-way HGV movements
- Drilling rig demobilisation: 20 two-way HGV movements
- Construction of production facilities: 1,200 two-way HGV movements
- Extended well test: 720 two-way HGV movements
Phase 2: production
- Rig mobilisation: 80 two-way HGV movements
- Drilling water injection well: 300 two-way HGV movements
- Drilling three production wells: 1,400 two-way HGV movements
- Rig demobilisation: 80 two-way HGV movements
- Construction of production facilities: 1,800 two-way HGV movements
- Production of oil: 7,300 two-way HGV movements
Phase 3: restoration
- Plugging and abandoning wells and site restoration: 20 two-way HGV movements
Noise
The application anticipates maximum daytime noise day of 55 decibels and 42 decibels at night during mobilisation, demobilisation, drilling and the extended well test during the day. During production it says there will be no increase over current background levels.
During site preparation, the application said:
“Noise would be mitigated at source and will include preventing the unnecessary revving of engines, switching off equipment when it’s not required, minimising the drop height of material, and starting up plant and vehicles sequentially rather than all together.”
During drilling, it said woodland between homes and the site would reduce noise levels at night. Traffic noise was described as “not significant” compared with current road traffic.
During production, the application predicted noise at nearby homes would be “very low and inaudible even on clam nights.
Ecology and nature conservation
Nearby habitat: semi-natural ancient woodland, scrub and standing water
Species: bat foraging and commuting; two active badger setts within 30m; nest sites for bird species in surrounding habitats.
Sites of Importance for Nature Conservation: 9 within 2km
Disturbance: The Non-technical summary concluded that emissions in phases 1 and 2 “may cause some disturbance to adjacent habitats”. But it anticipated “negligible effect” on habitats and “minor adverse effect” on bats. The effect on badgers was anticipated to be “moderate adverse” and an updated survey was recommended. According to the application, vibration and noise could deter reptiles and birds.
Impact on views and landscape
The Non-technical summary concluded
“There are no significant effects predicted on the Stansted to West Dean Wooded Estate Downland LCA. The woodland surrounding the site encloses and visually separates it from the undulating rural farmland such that the potential for effects on the LCA will be very localised”.
The application identified “some significant effects” on tranquillity and special qualities of the South Downs National Park. But noted “the site itself is not unspoilt”, it lies “within an intensively managed agricultural environment” and the “effects are fully reversible”.
It said the drilling rig would be seen from Northwood Farm, 720m to south west, and a barn 690m to south west. The also said the rig would be “perceived as conflicting with a small part of the surrounding wooded ridges. But “this will be temporary and not significant”.
Water and flooding
Site surface water features: None
Nearest pond: approx 750m at Northwood Farm
Flood risk: In Flood Zone 1 – low/very low risk of river or surface water flooding
Groundwater flood risk: some potential in low lying areas because of permeable geology
Foul water: Treatment on site or transported by tanker to disposal/treatment facilities. The application concludes that effects on water quality and flood risk would be negligible.
The application predicted the impact on groundwater quality would be negligible
National Park objectives
The applicant argued that the proposal met National Park objectives of enhancing the environment and promoting opportunities for understanding.
This would, it said, be achieved by:
“mitigating and designing out of impacts on the environment and enhancing measure for understanding the geology that underpins many of the special qualities of the National Park.”
The application argued that it fostered socio-economic wellbeing, another National Park duty, through
“the provision of minerals that will support the transport methods the National Park and its economy is dependent on.”
Site selection
The application said it had identified 12 possible sites for oil production in PEDL126. Of these, 10 were not considered appropriate because they could be seen from public rights of way and could not easily be screened. The Markwells Wood site was chosen because it had previously been “considered acceptable” for an oil operation.
